Grouting a tall wall means filling the cells of a reinforced masonry wall with high-slump grout to bond block, rebar, and footing into one structural unit. On large projects, contractors use one of three methods:
- Bucket brigade
- Grout pump
- Gravity-fed delivery system
What is Grouting?
Grout is a high-slump cementitious mix poured into the cells of a masonry wall to lock rebar, block, and foundation together. It is not mortar (the bedding between blocks) and it is not the thin tile grout used on bathroom floors. For tall structural walls, grout is what makes the assembly load-bearing.
Grout vs. Mortar vs. Concrete
Three cement-based materials get used on the same jobsite, and contractors confuse them often:
- Grout: 8 to 11 inch slump, flows into block cells, fills around rebar.
- Mortar: Stiff mix, bonds masonry units together at the joints.
- Concrete: Low slump, used for structural placements outside of masonry cells.
The key difference is water content. Grout is wet on purpose. The high water ratio lets it flow into narrow cells around rebar, and the surrounding block absorbs the excess water as it cures. This brings the final water-cement ratio back to where it needs to be for strength.
Why Grouting Tall Walls Is a Different Job
Tall walls multiply every grouting variable. Hydraulic pressure on the form increases with height, voids become harder to find and fix, lift heights are code-restricted, and reach matters more than ever. Methods that work for a 4 ft garden wall fail on a 24 ft gymnasium wall.
Code Basics: Lift Height, Slump, and Cleanouts
ACI 530.1/TMS 602 governs masonry grouting in the U.S. The code sets two main rules contractors must follow on tall walls: maximum grout pour and lift heights, and a slump range of 8 to 11 inches (10 to 11 inches for high-lift). Cleanouts are required for any pour over 5 ft 4 in.
Low-Lift vs. High-Lift Grouting

Low-lift means the wall is built and grouted in shorter sections, usually to scaffold height, without cleanout openings. High-lift means the full wall (or a tall section) is built first, then grouted from the top. The two methods have different code requirements:

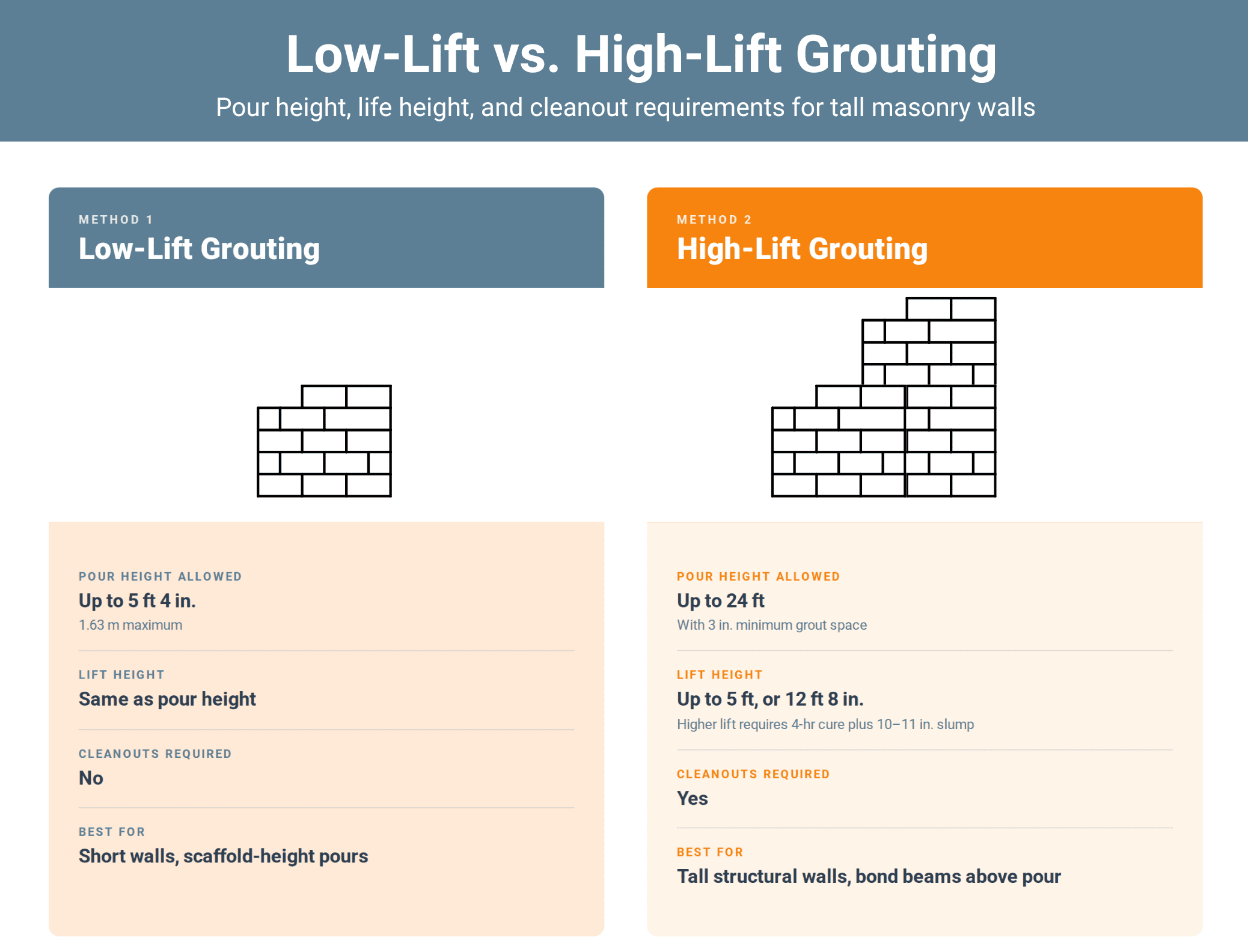

| Method | Pour Height Allowed | Lift Height | Cleanouts Required | Best For |
|---|---|---|---|---|
| Low-lift | Up to 5 ft 4 in. (1.63 m) | Same as pour | No | Short walls, scaffold-height pours |
| High-lift | Up to 24 ft (with 3 in. grout space) | Up to 5 ft, or 12 ft 8 in. with 4-hour cure plus 10 to 11 in. slump | Yes | Tall structural walls, bond beams above pour |
For deeper code background, the Concrete Masonry and Hardscapes Association publishes TEK 03-02A on grouting concrete masonry walls.
Slump, Aggregate, and Mix
Tall-wall grout has to flow. The mix specs reflect that:
- Slump 8 to 11 inches for standard pours; 10 to 11 inches for the higher 12 ft 8 in. lift.
- Coarse grout per ASTM C476 with aggregate that passes a 1/2 in. screen (roughly 3/8 in. nominal).
- Fine grout (sand only) for narrow grout spaces under 3 in.
- Self-consolidating grout (SCG) is allowed under code if cure conditions are met, and it eliminates the mechanical vibration step.
Contractors used to concrete mix design often resist the high slump. That instinct is wrong for grout. A stiff masonry grout will bridge and leave voids around rebar, which is the opposite of what the wall needs.
Three Methods for Delivering Grout to a Tall Wall
Each grouting method has a clear cost, crew, and reach profile. The right choice depends on wall height, jobsite access, forklift availability, and how many cubic yards have to move per hour.

Method 1: Bucket Brigade
Three or more workers carry buckets of grout up scaffolding and pour by hand. This is the slowest method, the most labor-intensive, and the hardest on the crew. It also makes precise placement difficult on tall walls. Useful only for very small pours on short walls where bringing in equipment is not justified.
Method 2: Masonry Grout Pump
A trailer-mounted or skid-mounted pump pushes grout through 25 to 50 ft of hose to a wall hook that drops into the block cells. Pumps work well when:
- The forklift is tied up with other masonry tasks.
- Site access blocks a forklift-mounted hopper.
- Vertical pumping is needed up to roughly 100 ft.
- Volume per hour is high.
Output ranges from 8 to 18 cubic yards per hour depending on the model and aggregate size. EZG’s Hog Pump® series handles up to 3/4 in. aggregate on the HP-20T4 and runs self-consolidating grout, lightweight concrete, shotcrete, and slurry on the HP-38 line. All Hog Pump models can be towed behind a truck, hydraulically powered from a skid steer, or skid-mounted, which provides flexibility on transport and power source between jobs.

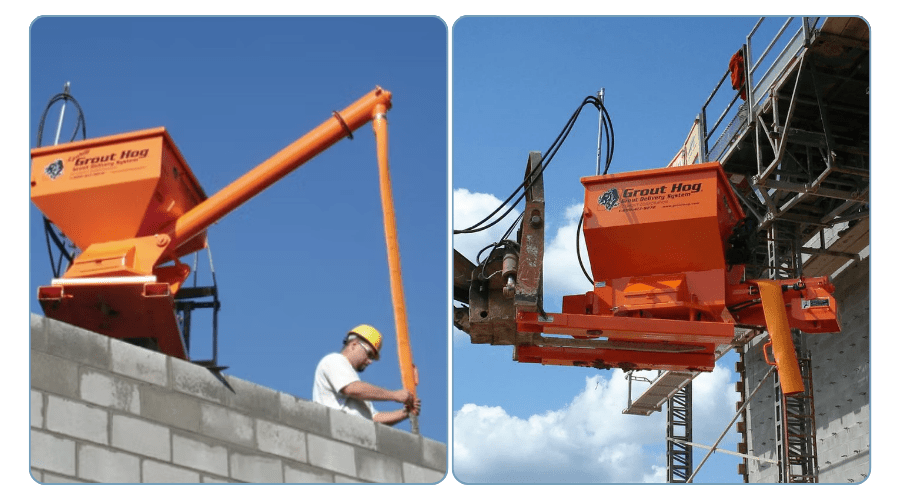

Method 3: Gravity-Fed Delivery System
A hopper with an internal auger and discharge hose, lifted into position by forklift or crane. The hopper sits above the wall and feeds grout into the block cells through a flexible hose. Two-person crew: one operating the forklift, one guiding the hose. EZG’s Grout Hog® discharges 3/4 cu. yd. in roughly 2.5 minutes and swivels 270° on its base to cover 17 ft of wall from one position without moving the forklift.
Method Comparison

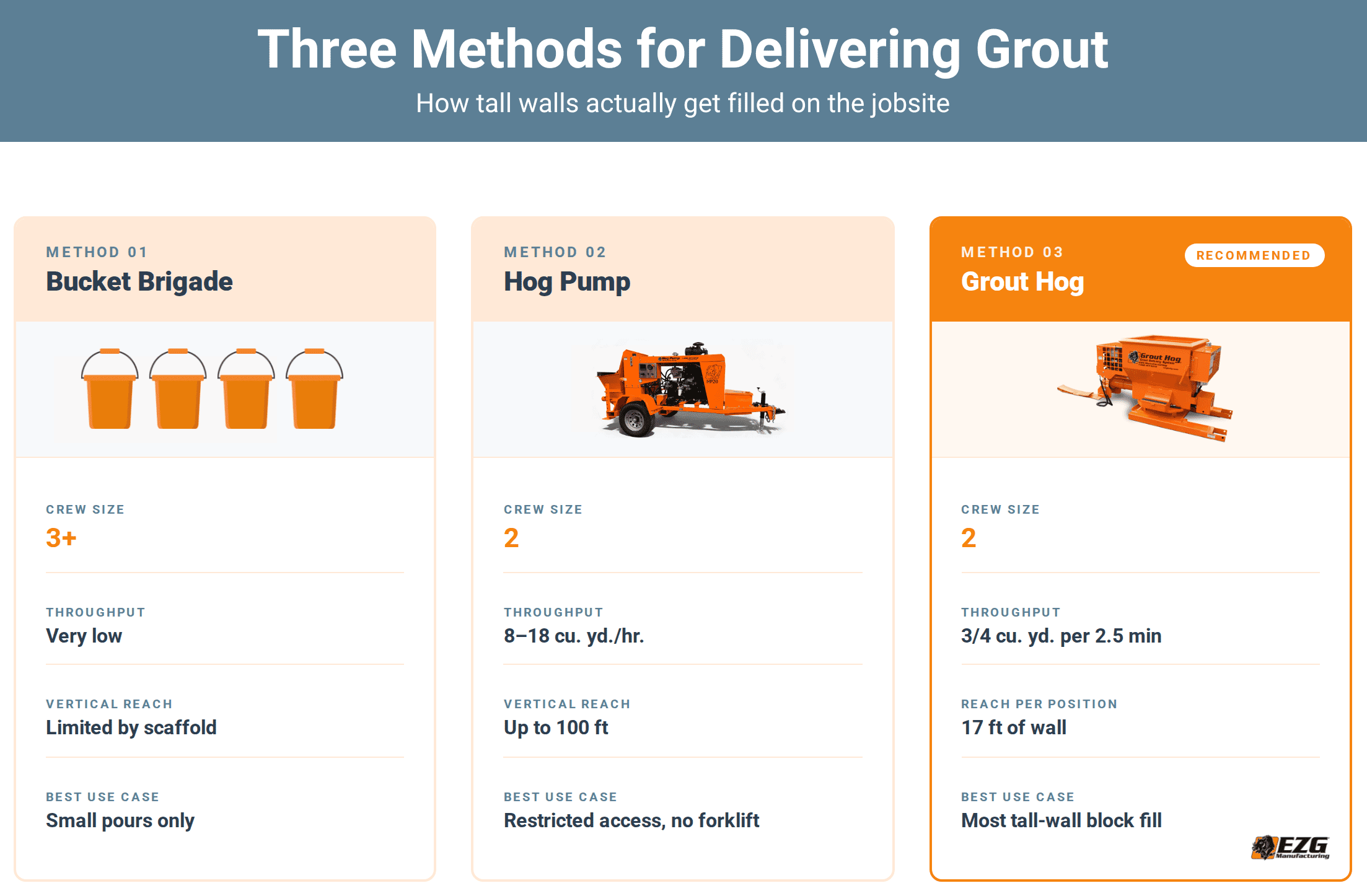

The three methods stack up like this on the metrics contractors actually care about:
| Method | Crew Size | Throughput | Vertical Reach | Best Use Case |
|---|---|---|---|---|
| Bucket brigade | 3 or more | Very low | Limited by scaffold height | Small pours only |
| Grout pump | 2 | 8 to 18+ cu. yd./hr. | Up to ~100 ft | Restricted access, no forklift, vertical lift over 25 ft |
| Gravity-fed delivery (Grout Hog) | 2 | 3/4 cu. yd. per 2.5 min | 17 ft per swivel position | Most tall-wall block fill |
For most exterior tall-wall block fill on commercial projects, the gravity-fed system is the productivity winner because the swiveling base eliminates forklift moves. For pours where access or vertical lift rules out a hopper, the pump is the answer. The bucket brigade survives only on the smallest pours.

Step-by-Step: How to Grout a Tall Concrete Masonry Wall
Grouting concrete masonry walls follows a fixed sequence: prep the cells, lay block to lift height, place rebar and cleanouts, mix grout to spec, deliver in lifts, consolidate, reconsolidate, and clean up. Following the sequence prevents voids, blowouts, and code failures on inspection.
Step 1: Prep the Wall and Cells
- Remove mortar droppings from the bottom of cells. Bridging here is a leading cause of voids.
- Confirm rebar placement and lap splices match the structural drawings.
- Install cleanouts at the base of cells for any pour over 5 ft 4 in.
Step 2: Cure the Masonry
Allow at least 4 hours of cure on freshly laid block before grouting. Cold weather may require longer. Grouting before the mortar has set is the fastest way to blow a wall out at the base.
Step 3: Mix to Spec
- 8 to 11 in. slump (10 to 11 in. for high-lift).
- Aggregate per ASTM C476.
- No retempering after the initial mix beyond what code allows.
Step 4: Deliver the Grout
- Use the chosen method (pump, gravity-fed system, or bucket).
- Deposit in the highest cell that allows the hose to reach.
- Keep the hose moving so material does not segregate in the line.
Step 5: Consolidate and Reconsolidate
- Vibrate each lift over 12 in.
- Reconsolidate after initial water loss to close the voids that form as block absorbs water from the grout.
- Skip mechanical vibration only if the spec calls for self-consolidating grout and the cure conditions in the code are met.
Step 6: Clean Up Equipment
- Flush the line and hopper before grout sets up.
- Quick-clean systems matter. The Grout Hog’s removable auger lets a crew clean the unit in roughly 15 minutes, which gets the equipment back on the next pour the same shift.
Common Tall-Wall Grouting Problems (and How to Avoid Them)
Each tall-wall grouting failure is preventable with proper cure time, the right slump, mechanical reconsolidation, and equipment matched to the pour volume.
Blowouts
Cause: Grouting before mortar has cured, or running a lift taller than code allows.
Fix: Hold the 4-hour minimum cure (longer in cold weather). Brace the wall per recognized standards. Reduce lift height if cure conditions are marginal.
Voids and Honeycombing
Cause: Skipped reconsolidation, wrong slump, or grout bridging on web protrusions or stray mortar.
Fix: Vibrate every lift over 12 in., hold slump to 8 to 11 in., and clean cells before the pour starts.
Cold Joints
Cause: Delays between lifts that let the lower lift set before the next one starts.
Fix: Plan deliveries so each lift gets placed before the prior lift initial-sets. Match equipment throughput to ready-mix delivery so material is moving the whole time.
Segregation in the Line
Cause: Aggregate too large for the hose, an unprimed line, or a hose run that is too long for the pump.
Fix: Match aggregate to equipment specs, prime the line with cement slurry before the first stroke, and use the shortest practical hose run.
Choosing the Right Equipment for Your Tall Wall
Pick equipment based on three factors: wall height, jobsite access, and how much grout has to move per shift. Forklift-mounted gravity systems suit most exterior tall-wall block fill.
When a Standard Grout Hog Wins
- Open exterior tall walls with forklift access.
- Forklift on site and available for the duration of the pour.
- Long wall runs where 17 ft of reach per swivel position cuts forklift moves.
- Mixed materials. The Grout Hog handles grout, sand, core fill, and even dry mixes, which most pumps cannot.
When the Uphill Grout Hog Wins
For interior tall walls, walls under bar joists, or any pour where the forklift boom cannot fully extend, the Uphill Grout Hog® is the better tool. The angled discharge reaches up under bar joists, gives roughly 20 in. of additional reach, and lets the operator keep the load lower for forklift stability. Lower boom extension also means a more stable load and a safer pour.
When a Hog Pump Wins
- No forklift available or the forklift is committed to other masonry work.
- Vertical lift over 25 ft to upper stories.
- Tight site access where a hopper cannot be flown in by forklift or crane.
A Note on Grouting Rock Wall Structures
Contractors grouting rock wall structures, which include reinforced stone walls and composite stone-faced masonry common on commercial projects, face the same code, slump, and consolidation rules covered above. The main difference is reach. Irregular face profiles make hose control harder, which is where a swiveling delivery hopper outperforms a fixed pump line. The same Grout Hog used on standard CMU walls handles these projects without modification.
Safety on a Tall-Wall Pour
Tall-wall grouting introduces fall risk, lifting injury risk, and equipment risk. The two-person crews enabled by gravity-fed and pumped delivery systems remove most manual lifting. Forklift safety pins, auto-shutoff valves, and remote operation keep crews out of the splash zone. A safety-planned pour is a faster pour.
The non-negotiables on a tall-wall site:
- Use safety pins or chains on any forklift-mounted hopper. Forks sliding off a loaded hopper at height can harm people.
- Never stand under an elevated load.
- Brace freshly laid masonry per the Standard Practice for Bracing Masonry Walls Under Construction from the Mason Contractors Association of America.
- Use remote or pendant control to keep the operator clear of the discharge.
- Confirm forklift load ratings before lifting a full hopper.
Why Contractors Trust EZG Equipment for Tall-Wall Grouting

EZG Manufacturing builds masonry delivery equipment that started as one contractor’s solution to clog-prone, undersized field equipment in 1998. CEO Damian Lang founded the company because the equipment available at the time was built cheap, broke often, and did not do what contractors needed. The first Grout Hog came out of that frustration and has been refined through patented clog-prevention features and an improved delivery system over the years since.
Today, the Grout Hog® and Uphill Grout Hog® are the gold standard for gravity-fed grout delivery on tall masonry walls. American built. Two-year warranty on parts. Designed and tested in the field by people who used to grout walls for a living.
If you have a tall-wall project coming up and you are not sure which delivery system fits the wall heights, access, and pour volume, contact the EZG team and we will help you spec the right machine for the job.
